Category: Business

  • Acoustic Performance on UK Domestic Jobs: What Part E Requires and How Builders Can Meet It Without Specialist Help

    Acoustic Performance on UK Domestic Jobs: What Part E Requires and How Builders Can Meet It Without Specialist Help

    Sound insulation is one of those things that gets ignored until someone moves in and can hear every word their neighbour says through the wall. Then it becomes a very expensive problem. If you are working on a house conversion, a flat above a shop, or even a new build with separating walls and floors, the Part E acoustic requirements are not optional and they are not someone else’s job. As a UK domestic builder, you need to understand what is required, what the testing looks like, and how to spec the right solution on site without bringing in an acoustic consultant every time.

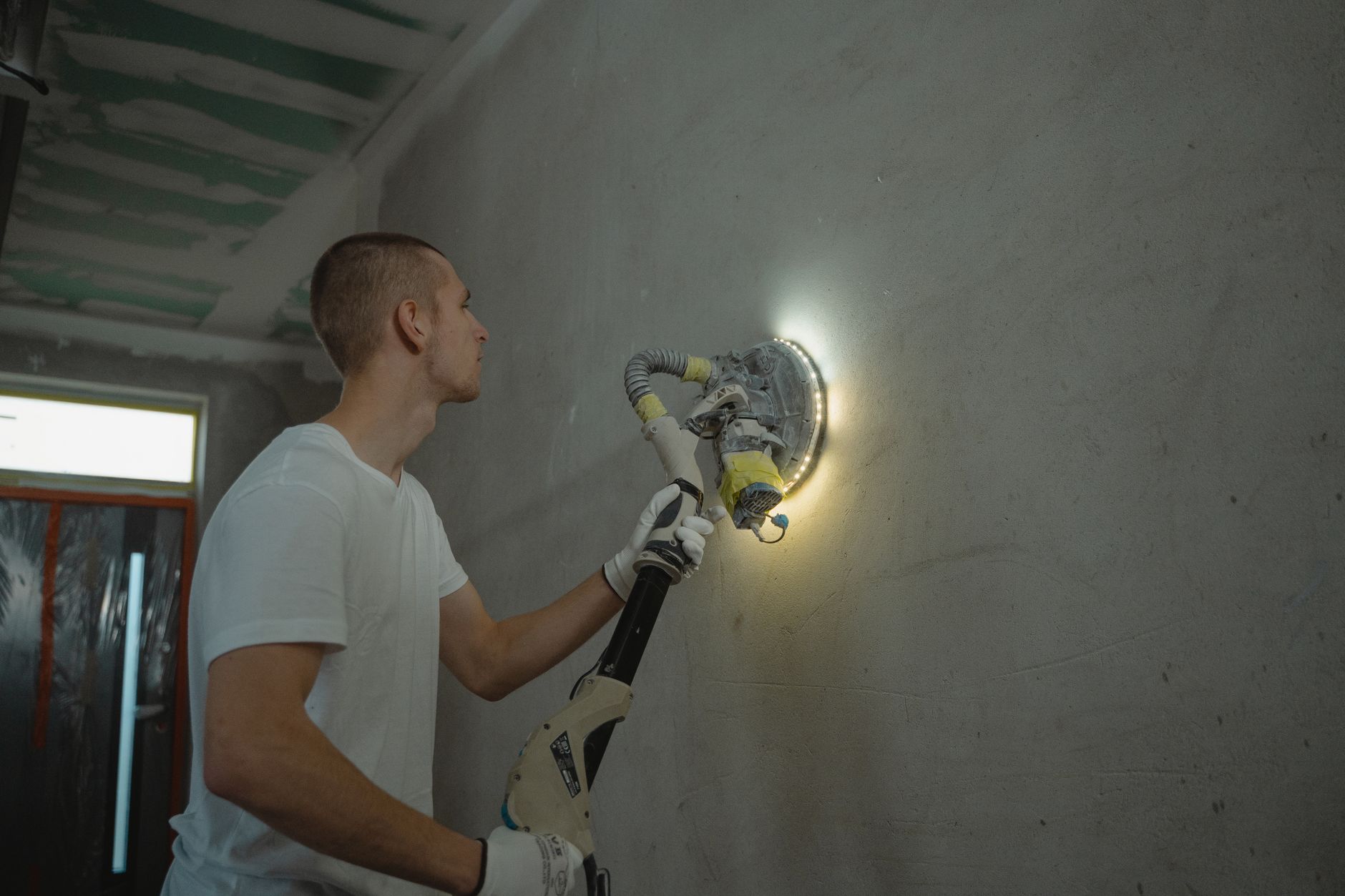

    Builder fitting acoustic mineral wool into stud wall framing to meet Part E acoustic requirements on a UK domestic conversion
    Photo by Tima Miroshnichenko on Pexels

    What Part E of the Building Regulations actually covers

    Approved Document E, published by the Ministry of Housing, Communities and Local Government, sets out the minimum acoustic performance standards for dwellings in England and Wales. It applies to new builds, material changes of use (so your house-to-flats conversions, commercial-to-residential jobs, and the like), and rooms for residential purposes such as student accommodation or care homes. Scotland and Northern Ireland have their own equivalent standards but follow broadly the same principles.

    The document deals with airborne sound transmission, which covers voices, music and television noise, and impact sound, which is footfall, dropped objects and that kind of structural vibration. Separating walls and separating floors are the main focus. Party walls between semi-detached or terraced houses, floors between flats, and walls between a flat and a stairwell all fall under its scope. If you are building a new separating wall or altering an existing one, Part E applies.

    The headline figures to know are: for new-build separating walls, the minimum airborne sound insulation is 45 dB DnT,w+Ctr. For separating floors in flats, airborne sound must hit 45 dB DnT,w+Ctr and impact sound must be 62 dB L’nT,w or lower (lower is better for impact). These are pre-completion testing values, measured in the finished dwelling, not theoretical values from a spec sheet. That distinction matters because flanking transmission through the structure can trash a perfectly good wall build-up if the junctions are not done right.

    When do you need pre-completion acoustic testing?

    For new-build dwellings, pre-completion testing is required unless you are using a Robust Detail scheme, which I will come to shortly. Testing must be carried out by a body accredited by the United Kingdom Accreditation Service (UKAS). The results go to building control before practical completion. Get this wrong and you are looking at remedial works after the plasterboard is on and the kitchen is fitted, which is nobody’s idea of a good time.

    For conversions, the standard is slightly more lenient: 43 dB DnT,w+Ctr for airborne and 64 dB L’nT,w for impact on floors. Still needs testing unless you can demonstrate pre-completion compliance through an approved route. If your project is small scale, one or two flats carved out of a Victorian terrace, building control will almost certainly ask for test results before they sign off.

    Robust Details: the builder’s shortcut that actually works

    Robust Details Limited operates a scheme that lets you register a separating wall or floor build-up that has already been tested and proven to pass Part E consistently. If you build to the registered specification, you do not need to carry out pre-completion testing on every plot. You pay a registration fee per dwelling (currently around £50 to £60 per plot), and you get an inspection regime instead. For volume house builders this is standard practice. For smaller builders doing a block of four or six flats, it is well worth looking at because the cost of UKAS acoustic testing, which can run to £800 to £1,500 per test series, quickly outweighs the registration fees.

    The Robust Details handbook lists specific wall and floor constructions. You pick one that suits your build method, register the plots, and then you must build exactly to that specification. No substituting cheaper mineral wool. No leaving out the resilient layer. The inspections catch cut corners, and if you have deviated from the spec, you are back to testing.

    Practical acoustic solutions for separating walls

    On a new-build separating wall between flats or between a semi-detached pair, the most common approach is a double-leaf masonry wall with a cavity, or a timber stud wall built to the Robust Details specification. I have used both, and my honest take is that masonry is more forgiving on site because it does not rely on every subcontractor understanding why the resilient layer must be continuous. Timber stud goes up faster but demands more attention to detail.

    For stud walls, a staggered stud arrangement works well. You run two rows of 50 mm timber studs on a 100 mm or 150 mm sole plate, alternating which leaf each stud connects to. The leaves never share a stud, so structure-borne vibration has nowhere to transfer. Fill the cavity with acoustic-grade mineral wool, typically 50 mm slabs at a minimum density of 10 kg/m³, and you are getting the absorption you need without adding excessive mass. Knauf’s Acoustic Roll or Rockwool’s RW5 slabs are the products I reach for most often. Both are widely available through builders’ merchants.

    Resilient bars on the receiving-room leaf of a masonry party wall are another solid option. The bars decouple the plasterboard from the masonry, breaking the direct transmission path. Fix them horizontally at 600 mm centres, use the correct screws at the correct length, and make sure the plasterboard edge does not touch the adjacent wall or floor. That edge gap, sealed with acoustic sealant, is critical. I have seen jobs fail testing because the plasterboard was nailed tight into the corner and every bit of isolation the bar provided was short-circuited at the perimeter.

    If you are working on a conversion where the existing wall is solid masonry, you are almost certainly adding an independent stud wall on the conversion side. This is similar work to the kind of internal wall decision-making covered in our guide on stud walls vs blockwork partitions, except the acoustic spec drives the build-up rather than structural or cost considerations alone.

    Getting floors right: the harder problem

    Separating floors are where builders most often run into trouble. Airborne sound is manageable with the right floor build-up. Impact sound is harder because you are trying to stop structure-borne energy at source, which means the soft layer must be under the floor finish or under the screed, not on top.

    A timber joist floor will typically need acoustic mineral wool between the joists (I use 100 mm full-fill as a minimum), a resilient layer on top of the decking such as a proprietary acoustic underlay or a floating floor system, and a heavy ceiling below. Platform floors with a proprietary system like a Bailey Total Floor (or similar) are a common Robust Detail solution and worth pricing in early. The extra cost over a standard floor is a few thousand pounds on a typical two-bedroom flat conversion. The cost of failing a test and ripping the floor back out is considerably more.

    On screed floors, you need the acoustic layer under the screed, not under the tile. The screed acts as the floating layer’s mass, and the acoustic board or mat beneath it provides the resilience. Make sure the screed does not bridge to the walls. Perimeter strips at the wall edge keep the floating mass isolated. Miss those, and you lose most of the impact sound reduction you paid for. This kind of detail is no different in principle to the care needed when specifying a cold or warm flat roof build-up where continuity of the insulation layer is the thing that makes or breaks the thermal performance.

    Flanking: the thing that catches builders out

    Flanking transmission means sound travelling around the separating element rather than through it. You can have a perfectly built separating wall and still fail a test because the flanking path through the floor, ceiling or the return walls is carrying too much energy. In a terraced house conversion, the front-to-back party wall at each end of the terrace is a common flanking route. Lightweight aggregate blocks perform better than dense concrete blocks for flanking control, which is why the Robust Details constructions often specify them at the junctions.

    At floor-to-wall junctions, a strip of acoustic mineral wool or a resilient layer bridging the gap between the floating screed and the wall face stops rigid contact. It is a five-minute job on site. Not doing it is a common and costly mistake.

    The same attention to junctions applies when you are thinking about the whole thermal and acoustic envelope. Our article on wet plaster versus dry lining touches on how the wall finish choice affects the overall performance of the wall system, and the same logic applies here: the finishing layer is part of the acoustic build-up, not an afterthought.

    A quick spec checklist for the site

    Before you start a separating wall or floor, run through this: Have you checked whether the project needs pre-completion testing or qualifies for Robust Details? Is your mineral wool the correct acoustic grade and density, not standard thermal wool? Are resilient bars fixed at the right centres with the right fixings? Is the perimeter of every floating element isolated with a strip or sealant? Have you briefed every subcontractor on what they can and cannot do to the build-up once it is in? If the answer to any of those is uncertain, sort it before the plasterboard goes on, not after.

    Part E acoustic requirements for a UK domestic builder are genuinely achievable without bringing in expensive consultants on most residential jobs. The information is in the Approved Document, the Robust Details handbook covers most common build types, and the materials are on the shelf at any decent merchants. The only thing that causes failures is cutting corners on the spec or not understanding why each layer is there. Know the why, and the how becomes straightforward.

    Frequently Asked Questions

    Does Part E apply to a single house converted into two flats?

    Yes. Converting a single dwelling into two or more self-contained flats is a material change of use, which brings the project under Approved Document E. The separating floor and any new party walls must meet the acoustic performance standards, and pre-completion testing is required unless you use an approved alternative route such as the Robust Details scheme.

    What is the difference between airborne and impact sound insulation?

    Airborne sound insulation measures how much a structure reduces airborne noise such as voices, music or a television. Impact sound insulation measures the structure’s resistance to structure-borne noise caused by physical contact, such as footsteps or dropped objects. Part E sets separate minimum values for each, and separating floors must comply with both.

    Can I use standard thermal mineral wool for acoustic purposes?

    Not reliably. Thermal mineral wool is designed for low thermal conductivity and tends to be lower density, which gives it poor sound absorption at the frequencies relevant to speech and footfall. Acoustic-grade mineral wool is specifically manufactured to a higher density that absorbs sound effectively. Always check the product data sheet and make sure the product is specified for acoustic use.

    How much does pre-completion acoustic testing cost in the UK?

    Typical costs for a UKAS-accredited pre-completion test run from around £800 to £1,500 depending on the number of test junctions, the location and the testing company. Registering plots under the Robust Details scheme costs around £50 to £60 per dwelling and removes the need for this testing, making it cost-effective on most conversion projects with more than one or two units.

  • RAAC Concrete in UK Buildings: What Tradesmen Need to Recognise and Report on Site

    RAAC Concrete in UK Buildings: What Tradesmen Need to Recognise and Report on Site

    If you were anywhere near the construction or facilities management world in 2023, you’ll know what kicked off that September. Schools across England were shutting classrooms overnight because their roofs contained Reinforced Autoclaved Aerated Concrete, and the structural engineers were saying some of it was on the verge of collapse. RAAC concrete identification in UK buildings went from niche surveying concern to front-page news in about a week. I’ve spoken to a fair few groundworkers and general builders since then who still aren’t entirely sure what they’re looking for, so let’s fix that.

    Structural engineer inspecting flat concrete roof deck relevant to RAAC concrete identification in UK buildings
    Photo by Shantum Singh on Pexels

    What is RAAC and why is it a problem?

    RAAC stands for Reinforced Autoclaved Aerated Concrete. It was used extensively in UK public buildings from the 1950s through to the mid-1990s, primarily in schools, hospitals, leisure centres and government offices. The material was cheap, relatively lightweight and easy to cast into flat planks and roof panels. The problem is that it was never designed to last more than about 30 years, and a significant chunk of it is now well past that point.

    Unlike standard structural concrete, RAAC is highly porous. Water gets in easily, and once it does, it attacks the thin steel reinforcement bar inside. Standard concrete has decent alkaline chemistry that protects the rebar. RAAC doesn’t, so corrosion spreads fast, the bar swells, the concrete cracks, and the panel loses structural capacity. There have been cases where panels have given no visible warning before failing. That’s the bit that makes engineers nervous.

    The government’s guidance on RAAC for building owners and managers is publicly available on gov.uk and worth bookmarking, particularly if you’re taking on any public sector or institutional refurbishment work.

    What does RAAC actually look like?

    This is where a lot of tradesmen get unstuck. RAAC is not immediately obvious on a casual walk-through. Here’s what to look for during strip-out or survey work.

    The material has a characteristic bubbly, cellular texture. If you snap a piece off or look at a cut edge, it resembles a rigid foam or a very coarse pumice stone. The voids are typically 1 to 3 millimetres across and distributed throughout the body of the concrete. Run your finger across a freshly exposed face and it will feel slightly grainy and soft relative to normal concrete. You can often scratch it with a nail or a key, which you certainly cannot do with standard dense concrete.

    In roof construction, RAAC appears as flat planks, usually somewhere between 75mm and 150mm thick, spanning between steel or concrete beams. The planks are typically 600mm wide and can span up to about 6 metres. You’ll often see them running in a single direction with visible joints between adjacent planks. On older flat roofs in schools and similar buildings, lifting the felt or the screed layer can expose these planks directly.

    Cracks running along the length of the plank rather than across it are a significant warning sign. So is any visible sagging, particularly at midspan. Staining on the underside of a ceiling, especially a concrete soffit in a flat-roofed section, is worth investigating. Don’t assume it’s just a historical leak.

    Where RAAC is most likely to turn up

    On domestic work, it’s rare. RAAC wasn’t widely used in housing. Your main exposure is on commercial refurbs, school extensions, health centre upgrades, sports hall strip-outs, or any public sector building put up between roughly 1955 and 1995. Local authority offices, swimming pools, libraries and further education colleges are all in the frame.

    The roof deck is the most common location, but RAAC was also used in floor slabs, wall panels and even some beam and plank floor systems. If you’re doing a temporary works or propping exercise in a building from that era before a structural alteration, it’s worth asking whether RAAC has been assessed as part of the structural survey. Don’t assume somebody else has already checked.

    I’ve seen cases where a builder was stripped out a suspended ceiling on a 1970s school annex and only noticed something was off because the planks above were lighter than expected when nudged and had that tell-tale pitted surface. That instinct to stop and question the material is exactly right. Trust it.

    RAAC concrete identification UK buildings: what you’re legally required to do

    If you’re working on a site and you suspect RAAC is present, you have obligations. Under the Construction (Design and Management) Regulations 2015, pre-construction surveys should have been carried out by the client or principal designer, and any known structural risks should be flagged in the pre-construction information. If RAAC hasn’t been identified in that documentation but you find what looks like it on site, you stop the work in the affected area and report it to the principal contractor or client immediately.

    The Health and Safety Executive takes RAAC seriously. HSE guidance is clear that where there is doubt about the structural integrity of any element, work must pause until a competent structural engineer has inspected and signed off on a safe method of working. You don’t carry on and hope for the best. A failed RAAC panel can drop without warning, and if there are workers or members of the public below, the consequences are obvious.

    Document what you’ve found. Take photographs with a scale reference if you can. Note the location in the building. Write it down in your site diary with a time and date. If the client pushes back and wants the job to continue without an engineer’s assessment, that pressure needs to be documented too. Your protection in any investigation comes from a clear paper trail showing you raised the concern and what response you received.

    Getting an assessment done

    A structural engineer with experience in RAAC assessment should carry out any formal inspection. The Institution of Structural Engineers has published guidance on this, and a good engineer will use a combination of visual inspection, non-destructive testing and in some cases coring to confirm material type and assess the condition of the reinforcement. Don’t rely on a general surveyor’s opinion if they haven’t specifically assessed RAAC before.

    For any building where RAAC is confirmed, a monitoring regime is usually put in place if immediate replacement isn’t possible. This involves regular inspections, load restrictions, and in some cases temporary propping below vulnerable panels. If you’re involved in the remediation work, the structural engineer will specify exactly what propping arrangement is needed. Follow that specification to the letter; this is not a situation for improvisation.

    Replacement typically means removing the existing plank deck and installing a new structural roof system. Depending on the building, that might be a new steel and concrete composite deck, a timber frame, or profiled metal decking. The choice will affect insulation specification too. If you’re replacing a flat roof deck, the distinction between a cold roof and warm roof build-up becomes relevant again, and you’ll need to ensure the new spec meets current Part L requirements.

    On the tools and on the lookout

    The broader lesson from the 2023 RAAC situation is that tradesmen are often the first people to physically touch these materials during a job, well before any engineer shows up. That puts you in a position of responsibility, even if nobody’s handed you a formal title for it. Knowing what RAAC looks like, where it’s likely to be found, and what to do the moment you suspect it is genuinely valuable knowledge for any builder or subcontractor working on older public or commercial buildings.

    If you’re regularly working on post-war institutional buildings, it’s worth adding a quick visual check of exposed structural elements to your standard strip-out process. Look at the texture. Look at the plank dimensions. Check whether it scratches easily. If something doesn’t look right, stop and ask. The job can wait. A collapsed roof panel can’t be undone.

    And if you’re tendering for any work in schools, NHS buildings or council-owned properties right now, ask during the tender stage whether a RAAC survey has been carried out. It tells the client you know your stuff, and it protects you from walking into a job where the structural picture hasn’t been properly established. The same diligence applies to specification work on wall systems in older stock, where hidden issues with the substrate can cause just as much grief down the line.

    Frequently Asked Questions

    How do I tell RAAC apart from normal concrete on site?

    RAAC has a distinctly porous, cellular texture with visible air voids throughout. It’s softer than dense concrete and can be scratched with a nail or key. If you’re looking at a flat roof plank that’s lighter than expected, around 75 to 150mm thick and roughly 600mm wide, with a bubbly cut face, treat it as suspected RAAC until an engineer says otherwise.

    Is RAAC only found in school buildings in the UK?

    No. Schools got the headlines in 2023, but RAAC was widely used in hospitals, leisure centres, libraries, council offices and further education colleges built between the 1950s and mid-1990s. It appears in roof decks, floor slabs and some wall panels in those building types.

    What should I do if I find suspected RAAC during a strip-out?

    Stop work in that area immediately and report it to the principal contractor or client. Document the location with photos and a written note. Do not carry on until a structural engineer has inspected and confirmed it’s safe to proceed. Under CDM 2015 regulations, this is a legal requirement, not optional.

    Can RAAC be repaired or does it always need replacing?

    In most cases where RAAC is deteriorated or showing signs of corrosion, full replacement is recommended rather than repair. Some monitoring and temporary propping schemes are put in place where immediate replacement isn’t feasible, but these are short-term measures. A structural engineer must advise on the appropriate course of action for each specific situation.

  • Cold Roof vs Warm Roof Flat Roof Construction: Getting the Insulation Position Right on UK Builds

    Cold Roof vs Warm Roof Flat Roof Construction: Getting the Insulation Position Right on UK Builds

    Flat roofs have a bad reputation in this country, and honestly, a lot of it is deserved. Not because flat roofs are inherently terrible, but because too many of them were built wrong. The biggest mistake I keep seeing on domestic jobs is getting the insulation position wrong. Cold roof or warm roof, it’s not a preference thing, it’s a structural and moisture decision that affects whether that roof lasts ten years or forty.

    If you’re detailing a flat roof on an extension, garage conversion or new build right now, this is the bit you need to understand before you order materials or book the roofer.

    Tradesman installing insulation during warm flat roof construction on a UK extension
    Photo by Irgi Nur Fadil on Pexels

    What’s the actual difference between a cold roof and a warm roof?

    A cold roof puts the insulation between or below the joists, at ceiling level, with a ventilated void above it. The structural deck and waterproofing membrane sit above that void, exposed to the cold. Hence the name. The idea was that the ventilated air space would carry away any moisture vapour that drifted up from the building below.

    A warm roof flips this around. The insulation sits on top of the structural deck, directly beneath the waterproofing layer. The deck and structure stay warm because they’re on the inside of the insulation. No cold zone, no ventilated void, no reliance on airflow to manage moisture. The whole roof build-up is continuous, from deck to membrane, with nothing left to chance.

    There’s also an inverted warm roof, sometimes called a protected membrane roof, where the insulation goes on top of the waterproofing rather than beneath it. You’ll see this more on commercial flat roofs and terraces, less on domestic work, but the principle is the same: keep the structure warm and away from moisture risk.

    Why cold roofs are increasingly hard to justify under current UK regs

    Part L of the Building Regulations sets minimum U-values for new roof constructions. For a flat roof on an extension or new build in England, you’re looking at a target U-value of 0.15 W/m²K under Approved Document L 2021. That is a low number, and achieving it with a cold roof design is genuinely difficult without making the overall build-up impractically thick.

    Cold roofs are also fighting against themselves when it comes to condensation. The ventilated void is supposed to remove moisture vapour, but in practice, getting adequate cross-ventilation across a wide flat roof is hard. British climates mean high humidity, and any restriction in the ventilation path, a poorly positioned vent, an obstruction in the void, insulation laid too thick and blocking airflow, and you get interstitial condensation forming on the underside of the cold deck. Over time, that moisture saturates the insulation, causes the timber deck to rot and can bring down the entire build-up from the inside.

    Building Control officers increasingly want to see condensation risk analysis, often a Glaser calculation or dynamic modelling, before they’ll sign off a cold roof detail. I’d argue that unless you’re retrofitting insulation to an existing cold roof where changing the build-up isn’t feasible, there’s very little reason to specify one on a new flat roof in 2026.

    PIR insulation boards being positioned on a warm flat roof build-up
    Photo by Towfiqu barbhuiya on Pexels

    How to detail a warm flat roof correctly

    The basic warm roof sequence, from inside out, runs like this: structural deck (usually 18mm or 22mm tongue-and-groove plywood or OSB), vapour control layer (VCL), rigid insulation board, and waterproofing membrane. Each of these layers matters, and the junctions between them are where most failures start.

    The vapour control layer

    The VCL goes directly on top of the deck, on the warm side of the insulation. Its job is to limit the amount of moisture vapour that gets into the insulation from the building below. It needs to be continuous. Every lap must be taped, every penetration sealed, every upstand detailed properly. I’ve seen jobs where the VCL was laid with untaped laps and gaps around pipe penetrations, and within three years the PIR insulation was damp and the waterproofing was bubbling. The VCL costs almost nothing relative to the roof as a whole; there is no excuse for a sloppy installation.

    Choosing and sizing your insulation board

    PIR (polyisocyanurate) board is the standard choice for warm flat roofs on domestic work in the UK. EPS (expanded polystyrene) is used on inverted roofs. For PIR, you’re typically looking at around 130-150mm to hit 0.15 W/m²K, depending on the product and the specific build-up. Manufacturers like Kingspan and Recticel publish U-value calculators specific to their boards, and I’d always verify the calculation rather than assume a thickness.

    Falls matter here too. Building Regulations and BS 6229 (the British Standard for flat roofs) both require a minimum 1:80 fall to outlets or eaves. On timber frame builds, you often achieve this with firring pieces (tapered battens) cut to the required slope and fixed on top of the joists before the deck goes down. Don’t try to achieve falls through the insulation alone; tapered insulation systems exist and work, but they need to be properly designed, not improvised on site.

    The waterproofing layer

    Single-ply membrane systems (TPO, PVC or EPDM) have largely taken over from felt on quality warm roof work. They’re lighter, more flexible, and better suited to the thermal movement that happens in a warm roof build-up where the insulation and membrane get hot in summer. EPDM in particular handles temperature cycling well and has a good track record on UK domestic flat roofs. For any job where the roof might also be used as a terrace or balcony, you’re looking at a more robust system with a protection layer over the membrane.

    Upstands at parapet walls and abutments need to be a minimum of 150mm above the finished roof surface, and the waterproofing must be dressed up behind the coping or flashing. This is one of those details that gets rushed and then leaks within two winters.

    Thermal bridges and why the perimeter detail matters

    Even with a perfectly detailed flat area, the perimeter is where heat loss and condensation risk concentrates. Where the warm roof insulation meets the external wall insulation (or lacks it entirely), you’ve got a thermal bridge. Part L requires you to account for linear thermal bridging in your energy calculations, and a badly detailed eaves junction can add significantly to the overall heat loss figure. If you’re also doing external wall insulation on the building, coordinating the EWI with the flat roof edge is critical to achieving continuity and eliminating cold spots.

    On extensions where the flat roof connects to an existing building, check the interface carefully. Masonry that was acceptable before insulation standards tightened can become a significant thermal bridge in the context of a well-insulated new roof. An SAP assessor or energy consultant can model this if you’re not sure, and it’s worth doing before you start rather than after.

    Structural considerations before you even get to the membrane

    Warm flat roofs are heavier than cold roofs of equivalent thermal performance, because all the insulation is on top of the deck rather than between joists where the void otherwise sits. Make sure your joist sizing accounts for the additional dead load. The temporary propping during construction also needs to account for point loads during installation, particularly if you’re using large-format insulation boards or mechanical fasteners for the membrane. For domestic timber-framed extensions, I’d always want a structural engineer to sign off the joist sizes rather than rely on span tables alone when there’s a warm roof on top.

    One more thing worth flagging: if you’re managing a project that involves multiple contractors and subcontractors, keeping your site admin and documentation tight matters as much as the build quality. Tools like project management software and organised supplier communication can make a real difference. Similarly, making sure your digital systems are reliable, from email to invoicing platforms, is basic housekeeping; I’ve seen jobs delayed because a contractor’s email was down and confirmations weren’t received, the kind of thing a managed DNS service like dijitul DNS is designed to prevent.

    Flat roof failures almost always come down to one of three things: wrong insulation position, inadequate VCL detailing, or poor upstand and perimeter work. The warm roof build-up solves the first problem by design. The other two are down to how carefully the job gets executed on site. According to guidance from the National Federation of Roofing Contractors, the majority of flat roof failures on domestic properties in the UK are linked to poor detailing at junctions rather than membrane failure in the field area. That should tell you everything about where to focus your attention.

    Get the insulation on the right side of the deck, tape every VCL lap, detail every upstand properly, and you’ll be fitting flat roofs that last. There’s no magic to it, just the right build-up in the right order with the right amount of care.

  • Wet Plaster vs Dry Lining: Choosing the Right Wall Finish System for UK New Builds and Refurbs

    Wet Plaster vs Dry Lining: Choosing the Right Wall Finish System for UK New Builds and Refurbs

    The argument over wet plaster vs dry lining UK jobs has been running on site for decades, and I still hear it every few weeks. One gang swears by the traditional three-coat system, the other lads roll up with a van full of board and adhesive dabs and are done before lunchtime. Both sides have a point. The right answer depends on what you’re building, who’s living in it, and how much of your margin you want to leave sitting in drying time.

    Plasterer applying wet plaster skim coat to a masonry wall, illustrating the wet plaster vs dry lining UK debate
    Photo by Tima Miroshnichenko on Pexels

    What the two systems actually involve

    Wet plastering covers a range from a full sand and cement scratch coat, float coat and finishing skim, right down to a bonding plaster base with a thin skim on top. On solid masonry walls, a two-coat bonded system is standard: bonding coat goes on first to key the surface, then a finish coat of either board finish or multi-finish skim goes over the top once it’s firm enough. The whole wall ends up around 12-15mm thick and rock solid. On external or damp-prone walls you’d look at a sand and cement render as the first coat before any plaster goes near it.

    Dry lining (dot and dab in most domestic settings) means fixing plasterboard directly to the masonry using blobs of bonding compound, then taping and jointing the boards or skimming the face. You can also frame out the room in a metal or timber stud system and screw the boards to that, though on solid walls most lads use the dot-and-dab approach. Either way, the finished wall is plasterboard rather than a continuous coat of wet material. Some contractors stop at a taped-and-filled finish using a jointing compound; others put a thin skim of board finish over the boards for a smoother result.

    Speed and programme: where dry lining wins

    This is the obvious one. A competent plasterer can skim a room after the dot-and-dab boards are up the following day. Wet plaster on solid masonry needs longer: the bonding coat wants at least 24 hours before the finish goes on, and the finish itself needs 3-5 days before painting, sometimes more in a poorly ventilated new build in winter. On a full new build programme that drying time adds up. Developers and main contractors moved to dry lining years ago largely for this reason, and the build industry has structured itself around it.

    I’ve priced plenty of new-build plots where the client expected a traditional skim finish throughout and then had a sharp intake of breath when the programme showed an extra two weeks on the plastering stage. It’s not that wet plaster is slow per se, it’s that the material needs time you often can’t give it.

    Cost comparison on a typical UK job

    Material costs vary by region and supplier, but as a rough benchmark: bonding plaster runs around £8-10 per 25kg bag, multi-finish finish plaster around £9-11, and you’ll get through more material per square metre than you might expect once you factor in wastage and coat thickness. For dot and dab, standard 12.5mm plasterboard is around £7-9 per sheet at a builders’ merchant (costs have stabilised a bit since the supply-chain chaos of 2023-24), and the adhesive dabs themselves are relatively cheap.

    Labour is where the difference really shows. A skilled plasterer charging £180-220 per day in most parts of England can skim around 25-30m² of already-primed bonding coat per day on a good run. A dry lining operative can dot-and-dab and board a significantly larger area in the same time, because there’s less physical effort involved in pushing wet material up a wall repeatedly. On a 200m² three-bedroom house, dry lining the inner faces of external walls will typically come in 15-25% cheaper on combined material and labour than a full bonding and skim, before you factor in any programme savings.

    That said, if you’re doing a traditional refurbishment of an older property, the cost comparison shifts. Chasing out walls, repairing historic plaster, and matching existing profiles often makes a wet system more practical than trying to board over irregular surfaces.

    Thermal performance and the energy efficiency question

    This is where the choice gets more interesting than most people expect. Standard dot-and-dab creates a cavity between the plasterboard and the masonry wall, typically 10-25mm depending on the wall’s flatness. That cavity isn’t insulated. In older solid-walled properties, this approach can actually create cold bridging and condensation risk at the dabs themselves if the detailing isn’t right. The government’s guidance on energy performance is pushing harder every year for walls to hit better U-values, and a plain dot-and-dab system doesn’t contribute much thermally.

    Insulated plasterboard (PIR-backed boards or mineral wool-backed systems) changes this calculation significantly. You can achieve meaningful improvements to a solid masonry wall’s thermal performance whilst still using a dry lining method, though the thickness increases and you lose more floor area. On a refurb where the client wants to improve their EPC rating, this is often the conversation to have before you pick up a float. I’ve written about EWI systems as an alternative when you want insulation without eating internal floor space, and that’s worth considering on jobs where the client can’t afford to lose 75mm off every external wall internally.

    Wet plaster on solid masonry, by contrast, leaves no cavity. There’s less risk of interstitial condensation in the wall build-up, and on older solid brick properties, some conservation officers actively prefer wet plaster because it allows the wall to breathe. That matters on pre-1919 properties where sealing the wall with a vapour-impermeable system can push moisture problems elsewhere.

    Acoustic performance

    Mass kills sound. Wet plaster adds mass to a wall; dot-and-dab removes it and creates a resonant cavity. On party walls and separating walls, Building Regulations Part E requires minimum sound insulation standards, and you cannot rely on plain dot-and-dab to hit them. You’ll need either a direct-fix resilient bar system with acoustic board, or a stud wall with acoustic insulation in the cavity. This is a common specification error I see on fast-track residential builds. The main contractor specifies dry lining throughout to save programme time, the acoustic testing at practical completion comes back marginal, and then someone’s paying to reopen walls. Worth pricing the right system first time.

    For guidance on choosing between stud and masonry construction internally, the comparison of stud walls vs blockwork partitions covers the acoustic and structural trade-offs in more detail.

    Which system suits which project type

    New build timber frame: dry lining is practically non-negotiable. The boards are fixed to the studs, the vapour control layer sits behind them, and wet plaster has no role at all. It simply doesn’t work on a timber frame structure.

    New build masonry (blockwork inner leaf): most contractors will dot-and-dab the inner faces of external walls and use a bonded skim on internal partition blockwork where the surface is flat enough. This hybrid approach is very common on speculative housing sites.

    Solid wall refurbishment (pre-1940 brick or stone): wet plaster is usually preferable on grounds of breathability, acoustic mass, and compatibility with the existing structure. If insulation is needed, discuss the options before defaulting to dot-and-dab; an insulated system done properly is better than plain dot-and-dab done quickly. The rising damp and penetrating damp question matters here too, and I’d always recommend a thorough diagnosis before any wall finish goes on. Covering a damp problem with boards or plaster just shifts it somewhere worse. For a clear overview of rising damp vs penetrating damp on UK properties, it’s worth reading before you spec the fix.

    Garage conversions and light commercial fit-outs: dot-and-dab on blockwork is generally the fastest and most cost-effective finish. Insulated plasterboard is worth specifying on external walls given the lower thermal mass of a garage structure compared to a house.

    Listed buildings and conservation areas: check with the local planning authority before anything goes near the walls. Wet plaster, lime-based where appropriate, is usually the only acceptable finish on significant historic fabric.

    The practical reality on site

    Most experienced tradesmen end up using both systems on the same job. External wall faces get dot-and-dab or insulated board; internal block partitions get a bonded skim if the surface is sound; areas around openings and reveals get finished wet. The key is specifying each part deliberately rather than defaulting to one system throughout because that’s what the last job used. Think about the thermal detail, the acoustic requirement, the drying programme, and whether the existing structure can handle any additional loading or moisture. Get those questions answered before the first bag gets opened.

    Frequently Asked Questions

    Is wet plaster stronger and more durable than dry lining?

    Wet plaster on solid masonry creates a harder, denser surface that resists knocks better than standard 12.5mm plasterboard. However, modern 15mm moisture-resistant boards are reasonably robust, and for most domestic settings both systems give a durable finish when correctly applied. The real durability difference shows up in humid rooms and areas prone to impact damage.

    Can you dot and dab onto old solid brick walls?

    Yes, but the wall must be reasonably flat, structurally sound, and free of active damp. On irregular old brickwork, the variation in wall face can make it hard to get the boards flat, and damp behind boards creates mould problems quickly. A full wet plaster system is often more practical on badly out-of-plumb solid walls.

    How long does wet plaster take to dry before painting?

    A bonding coat and finish skim on masonry typically needs a minimum of 4-6 weeks to fully carbonate and dry before a standard emulsion is applied, though in well-ventilated conditions with background heat you can sometimes paint after 3 weeks. Rushing it causes paint failure and trapped moisture. Dry lining with a taped-and-filled finish can be decorated far sooner, often within 24-48 hours of jointing.

    Does dot-and-dab reduce room size significantly?

    A standard dot-and-dab installation adds roughly 20-25mm to each wall face once you include the plasterboard thickness. On a 3m x 4m room with two external walls boarded, you lose around 50mm in each direction, which is noticeable in smaller rooms. Insulated plasterboard systems can add 50-100mm per wall, which is worth accounting for in your floor plan before you start.

  • Temporary Works on Small UK Building Sites: Props, Needles and Temporary Supports Explained

    Temporary Works on Small UK Building Sites: Props, Needles and Temporary Supports Explained

    Knocking out a loadbearing wall or underpinning a subsided corner of a Victorian terrace sounds straightforward enough until something moves that shouldn’t, and then you’re in serious trouble. Temporary works propping on UK domestic building sites is one of those areas where corners get cut all the time, usually because the job looks simple, the client wants it done fast, and everyone assumes it’ll be fine. I’ve seen lintels crack because props weren’t spread right, and I’ve spoken to subbies who had building control turn up mid-job and pull the brakes entirely because there was no temporary works plan in place. It’s not worth it.

    This guide is written for small contractors and one-man-bands who are taking on domestic beam installations, wall removals, and underpinning. We’re going to cover the kit, the process, the coordinator role, and the bits people routinely get wrong.

    Acrow props and needles supporting a loadbearing wall during temporary works propping on a UK domestic building site
    Photo by CONSTRUCCIÓN TOTAL on Pexels

    What is temporary works in a domestic context?

    Temporary works is the term for any structure or system put in place to support or stabilise a building or excavation while permanent work is carried out. On a domestic job, that usually means acrow props and needles supporting the floors and masonry above a wall you’re removing, or strutting used during underpinning to keep walls stable while you dig down in bays.

    The critical thing to understand is that temporary works are structural. They carry real loads. A poorly specified prop arrangement can allow settlement, cracking, or in the worst cases, partial collapse. The Health and Safety Executive is clear that duty holders are responsible for ensuring temporary works are designed and managed competently, regardless of the size of the site or the simplicity of the job in question.

    Needling and propping: what the job actually involves

    When you’re removing a loadbearing wall, the sequence matters as much as the kit. You’re transferring load from the wall above through a temporary system until the new beam or lintel is bedded in and cured. Get the sequence wrong and you load up the temporary arrangement unevenly, which causes differential settlement in the floor above.

    Needling involves drilling or cutting holes through the wall above the opening, sliding steel or timber needles through, and then hanging acrow props off those needles on both sides. The needles carry the load from the structure above directly down to the props, which sit on spreader plates or boards on the floor. The spreader plates are not optional. A prop foot landing on an unsupported floorboard can punch straight through or cause localised settlement in the floor below. I always use a minimum of a scaffold board under each foot, and on timber suspended floors I’d rather get a padstone down to the joist beneath than just trust the boarding.

    The props themselves need to be rated for the load. Standard acrow props are available in different sizes and load ratings. For a typical two-storey domestic job with a 3-metre beam, you’re routinely looking at loads that require you to double-prop or close-space props at no more than 600 to 900mm centres. A single prop each side for a long span is not engineering, it’s optimism.

    What is a temporary works coordinator and when is one legally required?

    A Temporary Works Coordinator (TWC) is the person responsible for overseeing the design, checking, installation, monitoring and removal of temporary works on a project. On larger sites this is often a structural engineer or senior site manager with formal TWC training. On a domestic job, it’s far more likely to sit with the contractor, and that’s where things get murky.

    Under BS 5975:2019 (the British Standard for temporary works procedures), a TWC should be appointed on any project involving temporary works. There is no minimum size threshold in the standard. The TWC doesn’t have to be an external professional on a simple domestic job, but they do need to be competent. That means they understand the loads, the kit, the checks, and the sequence. They also need to be independent from the commercial pressure to crack on.

    For underpinning specifically, or any situation where the structural arrangement is more complex (say, a prop arrangement spanning across a stepped floor, or temporary works interfacing with an excavation), you really should have a structural engineer signing off the scheme. LABC (Local Authority Building Control) can and do request to see temporary works drawings on notifiable projects, and if you can’t produce them, the job stops. I’d rather spend a few hundred pounds on an engineer’s temporary works note than lose a week of site time.

    Underpinning: temporary works in a different beast

    Underpinning uses a different form of temporary support called raking shores or horizontal struts, depending on the geometry. The principle of working in bays is critical: you never underpin adjacent bays simultaneously, because removing soil support across a continuous length of wall invites movement. The standard approach is to work in alternating bays of around 900mm to 1,200mm, completing and backfilling each bay before opening the next.

    Before any dig begins, the wall above needs to be monitored. That can be as simple as a tell-tale crack monitor glued across any existing cracks, which gives you a visible record of movement. If cracks are widening during the works, you stop, re-prop, and get an engineer to look. Anyone who tells you otherwise is taking a risk that isn’t theirs alone to carry.

    Steps small contractors commonly miss

    The first is load path tracing. Before you set a prop, you need to know what’s above the wall you’re removing. Is there a loadbearing wall above it on the first floor? Is there a chimney breast that transfers load through the structure? If you don’t trace the load path from roof level down, you might correctly prop for the first-floor load and completely ignore the second-floor contribution. I’ve seen this catch people out on 1930s semis where the first floor wall lined up directly above the ground floor wall being removed.

    The second is propping the floor above before you start cutting. On a two-storey job, if you start cutting without propping the ceiling joists, those joists start to sag the moment the wall comes out from under them. The sequence is: prop from below, needle through the wall above the opening, hang props on the needles, then cut. Not cut first and hope.

    The third is leaving the props in place long enough. For a standard padstone-and-steel-beam installation, you want the mortar or grout under that padstone to have achieved adequate strength before you strike the props. That typically means at least 48 to 72 hours, sometimes more in cold weather. Striking props after 24 hours to get the ceiling made good is a false economy.

    If you’re working on an extension where drainage and structural elements overlap, it’s worth reading up on getting your drainage layout right before you pour the slab, because conflicts between services and prop positions are more common than people think. And if the project involves internal partition changes as part of the same job, understanding the structural differences between stud walls and blockwork partitions will help you assess what else in the building might be carrying load.

    Documentation and sign-off

    BS 5975 requires a checking process before temporary works are loaded. That means someone (ideally not the person who designed the scheme) walks the installation and confirms props are plumb, spreader plates are down, needles are bearing correctly, and nothing has been improvised. This check should be recorded. A photo on your phone with a timestamp is better than nothing. A written check sheet is better still.

    When the temporary works are struck, that should also be recorded. Building control inspectors increasingly ask for evidence that temporary works were properly managed, especially on projects involving structural alterations. For anything requiring a practical completion certificate, having a clear record of how the temporary phase was handled protects you as the contractor.

    Get the propping right, document it, and don’t rush the strike. That’s the job.

    Frequently Asked Questions

    Do I need a structural engineer for temporary works on a domestic wall removal?

    Not always, but you do need a competent person to design and oversee the temporary arrangement. For straightforward single-storey domestic beam installations, an experienced contractor with a clear understanding of load paths may manage this. For anything involving complex load paths, underpinning, or multi-storey structures, a structural engineer’s sign-off is strongly advisable and may be required by building control.

    What is a temporary works coordinator and do I need one on a small job?

    A Temporary Works Coordinator is the person responsible for overseeing the entire temporary works process, from design through to striking. BS 5975:2019 recommends appointing one on any project involving temporary works, regardless of size. On small domestic jobs, this role often sits with the main contractor, but that person must be genuinely competent, not just the most available person on site.

    How many acrow props do I need when removing a loadbearing wall?

    It depends on the span and the loads above, but as a rough guide you should not have props spaced more than 600 to 900mm apart for a loaded double-storey wall. Always use spreader plates or scaffold boards under prop feet. A single prop each side on a long span is rarely adequate and should be confirmed against the actual load calculations.

  • Reclaimed Bricks on UK Renovation Jobs: How to Source, Match and Lay Them Without Causing Problems

    Reclaimed Bricks on UK Renovation Jobs: How to Source, Match and Lay Them Without Causing Problems

    Reclaimed bricks are everywhere on UK renovation sites right now. Listed buildings, Victorian terraces, Edwardian extensions, heritage estate work, you name it. Planners love them, clients ask for them, and yes, they can look absolutely right when you get the match spot on. But I’ve seen more than a few jobs go badly wrong because someone grabbed a pallet of second-hand bricks from a salvage yard without checking the basics. The bricks looked fine on delivery, crumbled by Christmas, or the mortar ate through them within a couple of winters. Reclaimed bricks UK renovation work demands a bit more thinking up front than most people give it.

    Reclaimed bricks stacked in a UK salvage yard, typical source for reclaimed bricks UK renovation projects
    Photo by Joseph Russo on Pexels

    Where to actually find reclaimed bricks in the UK

    The obvious first port of call is a reclamation yard. Companies like Thornhill Reclamation in Dewsbury, Salvo-listed yards across the country, and specialist salvage dealers in most large cities hold decent stock. Search the Salvo web directory for dealers near you. It’s the most established UK database of architectural reclamation suppliers and has been running for decades.

    Beyond the yards, demolition contractors sometimes sell direct when they’re clearing Victorian or Edwardian stock in bulk. Worth calling local demolition firms, especially if you hear about a terrace clearance or school demolition in the area. Prices vary massively. Handmade Victorians in good condition can fetch 80p to £1.50 per brick retail from a quality yard. Bulk demolition lots might come in at 30-50p, but you’ll have to clean them yourself and the yield once you’ve chipped the mortar off can be lower than you’d expect.

    Online platforms including eBay, Facebook Marketplace and Gumtree are also worth checking for smaller quantities, particularly when someone’s knocking down an outbuilding or garden wall locally. The main risk there is that photographs can hide a lot of damage. Always view in person before committing to anything structural.

    Checking compressive strength and frost resistance before you buy

    This is the part most people skip, and it’s the part that matters most for external work. Not all old bricks are equal. UK brick production up to the mid-twentieth century was far less standardised than modern manufacturing. Handmade soft red facings from the Home Counties are a completely different animal to a Staffordshire blue engineering brick, even if they look vaguely similar until you put a hammer to them.

    The current standard for new bricks is BS EN 771-1, but reclaimed bricks obviously won’t come with a test certificate. Your job is to make a reasonable assessment. Here’s what I look at on site:

    • Tap the brick sharply. A clear ring means dense, well-fired, generally sound. A dull thud suggests either underfired clay or frost damage that’s started breaking down the matrix.
    • Check for lamination. Run your thumbnail along the face. If layers start to peel or flake, the brick has already begun to delaminate, usually from frost cycles.
    • Look at the back and frog. Spalling, pitting and deep scarring on an unfaced surface can indicate a brick that’s been exposed on both sides for years and taken a battering.
    • Water drop test. Splash a small amount of water on the face. Bricks that absorb it almost instantly are high-suction units and will need wetting before laying. Bricks where it beads suggest a denser, lower-absorption clay, often more frost resistant.

    For anything going into an exposed external skin, a parapet wall, a chimney stack or ground-level plinth, you want bricks with a frost designation of F2 under BS EN 771-1 thinking. Without certificates, lean on the tap test, examine carefully, and if in doubt, use that stock for internal or sheltered positions only.

    Matching bond patterns on listed and period properties

    Getting the brick right and then laying it wrong will still fail a conservation officer inspection. Bond pattern matters, particularly on listed buildings and properties in conservation areas. On older UK domestic builds you’ll typically encounter:

    English bond: alternating courses of headers and stretchers. Common pre-1900, especially in areas with a strong local brick tradition like the East Midlands and Yorkshire.

    Flemish bond: alternating headers and stretchers in every course. Very common across Victorian and Edwardian housing stock throughout England.

    Stretcher bond: the dominant modern bond, usually only seen on pre-war work in cavity wall construction. If you see it on a solid wall, that’s generally a later repair.

    Photograph the existing bond from multiple angles before you demolish or open up any section. Measure the joint widths too. Joints on handmade brick walls from the Victorian era are often 12mm or more, quite different to the 10mm standard you’d use with modern pressed bricks. The conservation officer, if one is involved, will notice if your repairs tighten up the coursing. Keep a photographic record for your own protection as well, especially on listed work.

    On extensions or infill panels where you’re trying to match an existing elevation rather than replicate a historic bond, look at the coursing height. Count how many courses to a metre on the existing wall. Handmade bricks varied in bed depth, and the actual coursing height will differ from what you’d calculate using a standard 65mm brick plus 10mm joint. Adjust accordingly.

    Mortar mixes that won’t destroy softer reclaimed bricks

    This is probably where the most damage happens, and it’s a point I make on every job where someone’s repointing or laying reclaimed Victorian stock. A modern OPC-heavy mortar is too hard and too impermeable for softer handmade units. The rule is simple: the mortar must always be weaker than the masonry it’s bedding or pointing, so that any movement, moisture and thermal cycling is accommodated by the joint, not the brick face.

    For soft Victorian reds and similar handmade units, a standard NHL3.5 (natural hydraulic lime) mortar works well in most situations. A typical mix of 1 part NHL3.5 to 2.5 to 3 parts sharp sand is a solid starting point. For very soft units or very sheltered internal-ish positions, drop to NHL2. For harder, denser Victorian stocks or engineering bricks, NHL5 or a lean OPC mix becomes appropriate.

    Stay away from bagged ready-mix mortars unless you’re absolutely certain what’s in them. Many contain polymer additives that create a rigid, near-impermeable joint. Fine for modern blockwork, terrible for a handmade brick that needs to breathe. If you’re working on a property subject to listed building consent, it’s worth reading the Historic England guidance on mortars and pointing, which is freely available on their website and covers mix specifications in reasonable detail.

    This connects to wider decisions about working with older fabric. If you’re tackling a job that involves moisture, you’ll also want to be clear on whether you’re dealing with rising or penetrating damp before you start specifying repair materials, since the wrong diagnosis changes everything about how you approach repointing and repair. Similarly, if the job moves into insulating an older solid-wall property, understanding the risks around EWI specification on older buildings is worth doing before you commit anyone to a system.

    Practical tips before you order a pallet

    Order a sample batch first, at least 20 to 30 bricks, and lay them up in a small test panel on site if time allows. Check the colour match in natural light, not in a warehouse. Brick colours shift dramatically depending on light, and what looked right under fluorescent strip lighting will often read differently against the existing elevation at 10 in the morning.

    Factor in wastage. With reclaimed stock you should budget for 15 to 20% over your calculated quantity, sometimes more if the bricks are heavily mortared and you’re spending time cleaning them. Trying to go back to the same yard for a top-up three weeks later and get an identical match is a lottery at best.

    Finally, keep a record of your source. If a conservation officer, building control or your client queries the provenance of the material later, being able to say where the bricks came from and roughly what building they were salvaged from carries real weight. Some yards will provide a basic certificate of origin. It’s worth asking.

    Done right, a reclaimed brick job can look better than anything you’d get off a new facing brick pallet. It just takes more groundwork before the first brick goes down.

    Frequently Asked Questions

    Are reclaimed bricks suitable for external walls in the UK?

    Many are, but not all. You need to check frost resistance before specifying reclaimed bricks for exposed external positions. Use the tap test, check for lamination and spalling, and avoid any unit showing signs of previous freeze-thaw damage. Denser, well-fired bricks such as Victorian stocks and engineering bricks are generally safer for external use than softer handmade reds.

    What mortar mix should I use with soft reclaimed bricks?

    A lime-based mortar using NHL3.5 at roughly 1 part lime to 2.5 to 3 parts sharp sand is the standard starting point for soft Victorian handmade bricks. Avoid modern OPC-heavy mixes, which are too rigid and impermeable. The mortar must always be weaker than the brick itself to allow movement and moisture to be absorbed by the joint rather than the face.

    Where is the best place to source reclaimed bricks in the UK?

    Specialist reclamation yards are the most reliable source, particularly those listed on the Salvo directory. Demolition contractors clearing Victorian or Edwardian properties are another option, often at lower cost. Smaller quantities can be found locally through eBay, Facebook Marketplace or Gumtree, but always inspect in person before buying for structural use.

    Do I need planning permission to use reclaimed bricks on a listed building?

    Any repair or alteration to a listed building in England requires listed building consent, and the materials used including bricks and mortar must usually be approved by the local planning authority or conservation officer. Using inappropriate modern materials or the wrong bond pattern can result in enforcement action. Always consult your local authority before starting work on a listed structure.

    How do I match the bond pattern on an existing period property?

    Photograph and measure the existing bond before opening up any section of wall. Identify whether it is English, Flemish or another bond pattern, note the joint widths and count the courses per metre on the existing elevation. Handmade bricks often course slightly differently to modern pressed units, so always measure rather than assume standard dimensions.

  • External Wall Insulation Systems on UK Homes: EWI Specification, Fixing and the Mistakes That Cause Failures

    External Wall Insulation Systems on UK Homes: EWI Specification, Fixing and the Mistakes That Cause Failures

    External wall insulation has gone from a niche retrofit solution to one of the most commonly specified upgrades on British housing stock, and with good reason. Solid-wall properties, which make up a significant chunk of pre-1920s terraced and semi-detached housing across England and Wales, have nowhere near enough thermal resistance in the fabric alone. The problem is that EWI has also attracted a lot of rushed, under-specified work, and the failures I’ve seen on sites around the country are entirely avoidable if you understand the system properly from the start.

    Tradesmen fixing external wall insulation boards to a brick terraced house in the UK
    Photo by Mike van Schoonderwalt on Pexels

    This guide covers how external wall insulation systems are put together, how you specify and fix them correctly for both masonry and timber-frame substrates, how to detail around openings, and what corners get cut by installers who don’t really know what they’re doing. If you’re quoting EWI work, taking on a retrofit job, or just want to understand what you’re specifying, read on.

    What an EWI system actually consists of

    A proper external wall insulation system isn’t just a board stuck to a wall with some render on top. It’s a layered system, and every layer matters. From the substrate outwards, you’ve got adhesive mortar, the insulation board (typically expanded polystyrene, mineral wool or phenolic foam), mechanical fixings, a base coat render, reinforcing mesh embedded into that base coat, a primer, and then the finish coat render. Each component is usually specified together from a single manufacturer’s system, and that matters for warranty, performance and Building Regulations compliance.

    The two most common board types you’ll encounter are EPS (expanded polystyrene) and mineral wool. EPS is cheaper, water-resistant and easier to cut and handle. Mineral wool boards are more fire-resistant, which can make them the right call on taller buildings or where the fire strategy demands it. Phenolic foam boards give the best thermal performance by thickness, which is useful when you’re constrained on reveals around windows. The choice feeds directly into your U-value calculation, which ties back into the EPC rating improvements the client may be targeting or the building regulations requirement you’re working to.

    Substrate assessment before you spec anything

    The single biggest mistake I see on EWI jobs is skipping a proper substrate assessment. You cannot slap an EWI system onto a wall that has underlying moisture problems and expect it to perform. If there’s penetrating damp coming through failed pointing, render or window flashings, you’re trapping that moisture into the wall once you cover it over. Any rising or penetrating damp has to be identified and dealt with before a single board goes up.

    For masonry substrates, check the wall is sound, free from loose render, and that any existing cracked or hollow sections are cut back and repaired. Mortar joints that are soft or recessed need raking out and repointing first. On timber-frame construction, the assessment gets more involved; you need to check that the sheathing board is in good condition, that the existing breather membrane hasn’t failed, and that the timber studwork isn’t compromised by rot or movement. Pull-out tests for mechanical fixings are worth doing on unfamiliar substrates, particularly on aerated blockwork, which can give you a nasty surprise when the EPS board tries to come off in a gale.

    Fixing methods for masonry and timber frame

    On solid masonry, the standard approach is adhesive and mechanical fixing combined. The adhesive mortar goes on in a continuous perimeter bead plus dabs to the face of the board, giving a minimum of 40% coverage (some manufacturers specify 60% on exposed sites). Once the adhesive has cured sufficiently, you go back with hammer-in or screw-in fixings, typically five or six per board depending on the zone. The fixing count goes up at corners and perimeter areas because wind uplift loads are highest there. Use the manufacturer’s fixing design tables, not guesswork.

    Fixing length matters too. The fix needs to achieve a minimum embedment depth into sound masonry, usually 25mm minimum for brick and block, more for lightweight materials. If you’re going through existing render layers to get to solid masonry, account for that in your fixing length. Thermal bridging through metal fixings is a real issue, so specify plastic-headed fixings wherever possible; the insulation cap over the fixing head isn’t just cosmetic.

    Timber-frame substrates are a different approach. Here the boards are typically fixed mechanically through to the studs using longer fixings, with adhesive used as a temporary hold rather than a structural bond. Get your stud centres marked out accurately before the boards go up, and don’t rely on fixing into sheathing board alone. On any job that goes above two storeys, check whether you need a structural engineer’s sign-off on the fixing design.

    Close-up of reinforcing mesh being embedded in base coat render during external wall insulation installation
    Photo by Engin Akyurt on Pexels

    Detailing around windows and doors

    This is where a lot of EWI installs fall apart. The openings are the most thermally critical and the most vulnerable to water ingress, and poor detailing here is one of the main causes of system failure. A few things that have to be right:

    The window reveal is where you deal with the thermal bridge. Depending on the existing window position within the wall, you may be able to wrap insulation around the reveal and maintain a reasonable sill width. Where reveals are tight, thinner boards (phenolic or PIR) make sense. Every reveal needs proper starter track or bead, and the junction between the EWI system and the window frame needs to be sealed with an expanding foam sealant strip, not just render butted up to the frame. Render butted to a frame will crack; it’s not if, it’s when.

    Window cills need extending or replacing to account for the new wall thickness. This is a conversation to have with the client before work starts because it adds cost, and it’s something the better EWI installers price in from day one. Drip edges matter too; without a proper drip detail at sill level, water tracks back under the cill and starts working into the system.

    Above every opening, flashings and window head details need to direct water out and away. If the property has existing lintels that aren’t carrying adequate overhang, address this now. And check the eaves; the system needs to terminate cleanly at soffit level without leaving gaps that birds or insects can get into. Starlings, in my experience, are remarkably good at finding any gap around an EWI soffit detail.

    The render system and mesh reinforcement

    Once the boards are fixed and the detailing is done, the base coat render goes on with the reinforcing mesh fully embedded, not just laid on top. The mesh has to be lapped at joints by at least 100mm, and it needs to run continuously into all corner beads and around all openings. The mesh is what gives the render layer its crack resistance; skip it or do it badly and the finish coat will crack, usually within a couple of winters in a British climate.

    Let the base coat cure properly before the finish coat goes on. Manufacturers specify minimum cure times and they’re based on chemistry, not impatience. On silicone render finishes, the product goes on thinly; it’s not a levelling coat, so the base coat has to be flat before you get there. Coloured silicone renders have become the most popular finish on residential EWI in the UK because they’re flexible, water-repellent and don’t need painting, but they do show any underlying movement.

    What goes wrong when corners are cut

    On any retrofit job involving a scaffold, there’s cost pressure to get off-hire quickly, and EWI is an area where that pressure gets people into trouble. I’ve pulled boards off walls that were fixed adhesive-only with no mechanical fixings, on exposed gable walls, on three-storey terrace ends. That’s a safety issue, not just a performance one. The Building Regulations and the manufacturer’s system approval require both adhesive and mechanical fixing in most situations; you can’t just pick one because it’s quicker.

    I’ve also seen jobs where the reinforcing mesh was trowelled in dry, straight over a thin skim of base coat, with the boards behind not properly adhered. Wind gets behind it, the system moves, the render cracks and lets water in, and within two years you’re looking at a refit. And once water gets behind an EWI system, you’ve got a real problem to unpick.

    On external services, it’s easy to miss things during the survey. Boiler flues, outside taps, electricity meter boxes, TV Aerials and satellite brackets all need accounting for before the scaffold goes up. Cutting around them after the fact is where the messy details come from. Get every external penetration logged at survey, agree how each one gets dealt with, and make sure it’s in the specification.

    EWI done properly is one of the highest-impact fabric upgrades you can carry out on a solid-wall property. The margin is decent, the demand is there, and if you’re already doing extension or retrofit work, the skills transfer directly. If you’re also handling internal wall partitions and layout changes as part of a wider retrofit, have a look at how stud wall and blockwork partition choices interact with your thermal strategy. Get the spec right, detail around the openings properly, and don’t let anyone rush the mesh and render stages. That’s where the failures live.

  • Converting a Garage into a Workshop or Hobby Room: What UK Builders Need to Know About Regulations, Insulation and Services

    Converting a Garage into a Workshop or Hobby Room: What UK Builders Need to Know About Regulations, Insulation and Services

    Garage conversions are one of those jobs that look simple on paper but come with a surprisingly long list of regulatory hoops. I’ve seen plenty of tradesmen take on what the client describes as “just turning the garage into a hobby room”, and then get caught out halfway through because nobody checked whether building control was actually required. Let’s cut through the vagueness and talk about what the rules actually say, what materials and services you need to spec correctly, and where people consistently go wrong.

    Garage conversion to workshop mid-build showing stud wall insulation and concrete floor preparation
    Photo by Luis Quintero on Pexels

    Does a garage conversion to workshop require building regulations?

    Short answer: almost certainly yes. If you are converting a garage into any form of usable habitable or semi-habitable space, including a workshop, hobby room, home gym, or studio, building regulations will apply in England and Wales. This is not optional and it is not covered by permitted development rights in the same way that planning permission sometimes is.

    The key distinction is that planning permission and building regulations are two completely separate things. A garage conversion to workshop use may not need planning permission at all if it remains ancillary to the dwelling and you are not changing the external appearance significantly. But building regulations sign-off via building control, either through the local authority or an approved inspector, is required for a material change of use. Converting a garage from an unheated, uninsulated storage space into a conditioned room counts as exactly that.

    Submit a building regulations application before work starts. Do not assume that because the client got planning approval, they are sorted. They are not.

    Part L compliance: insulating the floor, walls and roof

    Part L of the Building Regulations covers energy efficiency, and it bites hard on garage conversions. The reason garages are cold, damp and generally miserable is precisely because they were never built to any thermal standard. Your job is to bring them up to scratch, and the threshold values you are working to are set out in the Approved Document L for dwellings.

    For a garage conversion, typical minimum U-values you will need to achieve are around 0.28 W/m²K for the walls, 0.18 W/m²K for the roof or ceiling, and 0.22 W/m²K for the floor. These are not wildly difficult targets, but they do mean you cannot just stick a layer of 25mm polystyrene on the walls and call it a day. The floor is often the awkward one. If the existing slab is at a low level, you may need to raise the finished floor height with a rigid insulation board beneath a screed or floating floor deck, which then has knock-on effects on thresholds, door frames and drainage if there is any.

    On the walls, you are usually looking at either a stud frame with mineral wool batts built against the masonry, or rigid board fixed direct to the blockwork. Both work. The stud frame approach gives you better insulation depth and somewhere to run services cleanly, but it does eat into floor area. On a tight single garage that is already cramped, that matters. I tend to lean towards a 70mm or 90mm stud with full-fill mineral wool plus a 12.5mm plasterboard finish, straightforward, achievable, and it passes.

    The garage door opening is another area that trips people up. In most conversions, the client wants a window or solid wall where the door was. That new section needs to match the thermal and structural spec of the rest of the build. A lintel, a proper cavity or solid wall build-up, and a correctly specified window if one is going in. For more detail on lintels and structural spec for new openings, the team have covered stud walls versus blockwork partitions for UK internal wall systems, which is worth a read alongside this.

    First fix electrical wiring in a garage conversion to workshop stud wall cavity
    Photo by Pavel Danilyuk on Pexels

    Part P and electrical circuits in a garage workshop

    If the space is being used as a workshop, the electrical installation is not a minor afterthought. Part P of the Building Regulations governs electrical work in dwellings, and any new circuit added to the consumer unit, or any rewire of an existing circuit in a garage conversion, must either be carried out by a registered electrician under a competent person scheme or notified to building control separately.

    For a workshop specifically, the electrical spec needs to be robust. You are likely looking at at least one dedicated 32A radial circuit for power tools, adequate 13A socket circuits (and more of them than you think you need), task lighting circuits, and potentially a 16A commando-style outlet if the client wants a welder or compressor. Earthing and bonding in a garage space, which may have exposed metalwork and damp ingress risk, needs proper attention. RCD protection on all circuits is non-negotiable under current wiring regulations.

    Get a qualified electrician in early, before the plasterboard goes up. I have been on jobs where the first fix electrical was done properly and the building inspector was happy on the first visit. I have also been on jobs where the owner decided to do it themselves, notified nobody, and then had to have a wall opened up after the event. Do it right the first time.

    Ventilation: the part most people forget until it goes wrong

    Part F of the Building Regulations covers ventilation. A habitable or work room needs background ventilation and, depending on the use, mechanical extract or purge ventilation. For a hobby room or general workshop, at minimum you will need background trickle ventilation via window heads or equivalent, and the ability to purge air rapidly (opening area equivalent to 1/20th of the floor area is the standard benchmark).

    If the workshop involves any finishing work, spraying, welding, or solvent-based materials, proper mechanical extraction becomes a health and safety requirement, not just a building control box to tick. The HSE guidance on workshop dust and extraction is worth passing on to the client as part of your handover documentation. Carpenters and hobbyist woodworkers in particular often underestimate how quickly fine dust builds up in an enclosed space.

    In an attached garage, also consider whether the conversion creates any combustion air problems for a boiler in an adjacent utility room. If the original garage was the source of combustion air for a gas appliance, you may need to review that arrangement with a Gas Safe engineer before sealing the space up.

    Dampness, floors and sub-base: getting the fabric right first

    Garages are typically built on a thin concrete slab with no damp-proof membrane, or with a DPM that has never been linked to the house’s main DPC. Before any insulation or floor build-up goes in, check the existing slab for moisture. A surface hygrometer reading or a simple polythene sheet taped down for 72 hours will tell you what you are dealing with.

    If there is moisture rising, you need to address it before the floor build-up goes in. A liquid-applied DPM or an epoxy-based tanking coat on the slab surface is typically the right call here. Getting this wrong means the client has a damp, mouldy floor within a season, and that conversation is one nobody wants. For further reading on how sub-base choice affects moisture outcomes in groundwork situations, the piece on choosing the right sub-base material for UK groundworks covers the principles well.

    Once the slab is sorted, a rigid PIR or EPS insulation board, DPM if not already applied, and a floating chipboard or screed deck gives you a solid finished floor. For workshops, 22mm tongue-and-groove P5 chipboard on a floating insulation deck is practical and tough enough for most hobby use. If the client wants a proper workshop with heavy machinery, consider a poured screed over the insulation for added mass and durability.

    When to get building control involved and what sign-off looks like

    Submit your building regulations application before breaking ground. You have two routes: a full plans application (you submit drawings and spec upfront, they are approved in principle before work starts) or a building notice (you notify them and they inspect as work progresses). For a garage conversion, a full plans application is generally the better choice because it gives you and the client certainty before spending money on materials.

    Inspections typically happen at foundation/slab stage (if any groundwork is involved), first fix (before plasterboard goes up, so the insulation, framing, and services can all be checked), and final completion. Get those inspections booked in advance. Building control officers have full diaries, and a missed inspection can hold up a job for days.

    Once sign-off is issued, the client gets a completion certificate. This matters if they ever sell the property, because solicitors will ask for it. Skipping building control does not just put the tradesman at risk during the job; it lands the client with an undocumented conversion that complicates the sale years down the line.

    If your client is thinking about how the finished space will actually feel and function once the building work is done, there is a related article, how to create a dedicated hobby space at home that actually makes you happier every day, which is worth sharing with them when you hand over the keys to the finished room.

    Common mistakes on garage conversions and how to avoid them

    In my experience, the most frequent problems are: starting work before submitting a building regulations application; not achieving the Part L U-values because the insulation spec was too thin to save space; and skipping the electrical notification under Part P because the client insisted on doing it themselves. None of these are hard to avoid with a proper pre-start conversation.

    The other one I see regularly is failing to link the new DPM in the floor to the existing DPC in the walls. If those two elements are not connected, moisture will track up the junction and cause problems regardless of how well the rest of the floor is built. It takes ten minutes to do it correctly and saves a callback months later.

    Do the job properly, get the paperwork in order, and the client has a genuinely useful space that adds real value to their home. Cut corners on the regulations and services, and someone, usually the tradesman, ends up paying for it.

    Frequently Asked Questions

    Do I need building regulations approval for a garage conversion to workshop in the UK?

    Yes. Converting a garage into a workshop or hobby room is classed as a material change of use under the Building Regulations in England and Wales, so building control sign-off is required. This applies even if you do not need separate planning permission for the project.

    What insulation thickness do I need for a garage conversion under Part L?

    Target U-values under Part L are approximately 0.28 W/m²K for walls, 0.18 W/m²K for the roof or ceiling, and 0.22 W/m²K for the floor. In practice this typically means 70-100mm of mineral wool or rigid PIR board in the walls, 100mm or more in the roof, and 75-100mm rigid insulation beneath the floor deck.

    Does the electrical work in a garage conversion need to be done by a qualified electrician?

    Under Part P of the Building Regulations, any new circuit or consumer unit work must either be carried out by an electrician registered under a competent person scheme such as NICEIC or NAPIT, or separately notified to your local building control. Self-certification without registration is not permitted for new circuits.

  • Landscaping After a Build: How UK Tradesmen Can Offer Driveway, Patio and Path Work to Boost End-of-Project Revenue

    Landscaping After a Build: How UK Tradesmen Can Offer Driveway, Patio and Path Work to Boost End-of-Project Revenue

    Most builders I know walk off site the day practical completion gets signed and leave a garden that looks like the surface of the moon. Mud, rubble, broken flags, maybe some leftover timber propped against the fence. The client is chuffed with the extension but the outside still needs sorting, and nine times out of ten they’d happily pay the same builder to do it rather than find someone new. That’s money sitting on the table.

    Hard landscaping, driveways, patios and paths, is one of the cleanest upsells available at the end of a building project. You’ve already got the client’s trust, you know the site, and you’ve probably got plant and labour on hand. Understanding driveway paving regulations as a UK tradesman is the bit that trips people up, so let’s go through the whole picture: the planning rules, the sub-base requirements, the materials, and how to price it so you’re actually making money.

    Tradesmen laying block paving driveway, relevant to driveway paving regulations for UK tradesmen
    Photo by Max Vakhtbovych on Pexels

    The planning rule every UK tradesman needs to know about driveways

    Driveways are not a planning-free zone. Since October 2008, covering more than 5 square metres of front garden with an impermeable surface requires planning permission unless the water drains to a lawn, border or soakaway within the property. This comes from the Town and Country Planning (General Permitted Development) (England) Order 2008, and the government’s own guidance on when planning permission is required covers it clearly.

    In practice, this means two things for you on site. First, if a client wants a solid concrete or standard block-paved driveway and their front garden is over 5 square metres, you either need to check they’ve got permission or you steer them towards a permeable surface. Second, permeable block paving is actually a brilliant upsell in its own right because it sidesteps the planning question entirely and you can pitch it as the lower-hassle, higher-spec option.

    Permeable paving works by allowing water to pass through joints or through the blocks themselves, into a sub-base that acts as temporary storage before the water infiltrates into the ground. The key is getting that sub-base right, and that starts below the surface.

    Getting the sub-base right for block paving and permeable surfaces

    A block paving job that fails in two years fails in the sub-base, full stop. I’ve seen driveways laid over compacted soil with barely 75mm of MOT underneath, and they sink the first time a Transit parks on them. For a standard residential driveway carrying light vehicle traffic, you’re looking at a minimum of 150mm of compacted Type 1 granular sub-base on a stable formation. For anything that might see heavier vehicles, push that to 200mm.

    For permeable block paving specifically, the build-up is different. Rather than a bedding sand, you use a 6mm clean angular grit or crushed granite bedding layer, typically 50mm deep, and the sub-base itself needs to be open-graded, usually Type 3 or a proprietary permeable sub-base blend, to allow water to move through it. Don’t use Type 1 for a permeable system. It’s too dense. The whole point is free drainage, and fine material will choke it.

    If you’re already pricing a groundworks package on a project, this pairs naturally with the same thinking I covered in the article on choosing the right sub-base material for UK groundworks. The principles are consistent: match the material to the load and drainage requirements, compact it properly in layers, and don’t skip the formation check before you start building up.

    Edging, drainage channels and the details that justify your price

    Where a hard-landscaped area meets a public highway or discharges towards a neighbour’s boundary, you need to manage the water. On permeable surfaces you’ve got infiltration doing the work, but on an impermeable patio or path you need either a cross-fall towards a planting border or a drainage channel directing water to a surface water drain or soakaway. Building Regulations Part H covers drainage, and it’s worth being clear with the client that it’s not optional.

    Edging is where cheap jobs become expensive problems. Block kerbs or haunched concrete edge restraints stop the outer blocks spreading under load. I’ve been called back to jobs where someone cut corners with plastic edge restraints on a driveway, and within a year the whole edge had kicked out. Haunch it with a C20 mix, let it cure, then lay your blocks. It adds maybe an hour’s work and saves a call-back six months down the line.

    Small details like this are also what you use to justify your day rate. A client comparing your quote to a local one-man-band who doesn’t mention sub-base depth or edge restraints doesn’t know what they’re comparing. Spell it out in your quote. “150mm permeable sub-base, haunched kerb edge, permeable block paving, sand and brush finish” is a different product to “driveway laid on hardcore.” Make them see the difference.

    Realistic day-rate margins on hard landscaping

    Hard landscaping is labour-intensive but the margin potential is solid if you price it properly. A two-man team can reasonably lay around 40 to 50 square metres of standard block paving per day, including prep and edging on a pre-excavated site. On a permeable system, allow slightly less, say 35 to 45 square metres, because the sub-base build-up is more careful work.

    Materials for block paving in 2026 run roughly £20 to £40 per square metre depending on the block spec, plus sub-base, bedding, edging and any drainage channel. Labour at a two-man team rate varies by region but £350 to £500 per person per day is a reasonable working figure across most of England. On a 60 square metre driveway you’re looking at a minimum two-day job with a crew, so total project cost before your margin sits somewhere between £3,000 and £5,000 depending on spec and location. Charge accordingly.

    Don’t forget to factor in skip hire and excavation if you’re digging out an existing surface. That’s a day in itself on a typical domestic driveway once you account for loading and disposal. On extensions where groundworks are already involved, you might be able to use on-site plant time more efficiently, which is part of why the end-of-project upsell works so well financially.

    How to position the upsell without being pushy

    The best time to mention landscaping is not at the end of the job, it’s during the main build. If you’re mid-extension and the client is pleased with how things are going, drop it in naturally. “Once we’re done inside, do you want me to price up sorting the front and back? I know exactly what’s needed out there now and it’ll be less disruption than bringing someone else in.” Most clients say yes to that conversation.

    If you’re taking on retrofit or refurb work alongside energy upgrades, hard landscaping often ties in with drainage improvements, particularly around extensions where new drainage runs have been cut in. The work I covered on extension drainage layout before pouring the slab is directly relevant here, because a well-planned drainage route during the main build makes the external landscaping phase much cleaner to execute.

    Present the landscaping work as part of completing the project properly, not as an extra. Clients don’t want a finished extension and a ruined garden. They want the whole thing done. You’re the person who already knows the site, has the contacts for materials, and understands what’s been disturbed underground. Use that.

    Scotland, Wales and Northern Ireland: check local rules

    The 2008 permitted development change applies specifically to England. In Scotland, Wales and Northern Ireland, the rules differ, and you should check with the relevant local planning authority before advising clients. Wales has its own Technical Advice Notes and planning policy, and Scotland’s permitted development rights are set out under the Town and Country Planning (General Permitted Development) (Scotland) Amendment Order. Don’t assume England’s rules apply everywhere, particularly if you’re working across borders.

    Hard landscaping at the tail end of a build is one of the cleaner ways to add revenue without taking on a new client acquisition cost. You’ve already done the hard work of winning the trust. Price it properly, sub-base it correctly, and make sure you understand the driveway paving regulations that apply as a UK tradesman. The job sells itself once the client sees what a proper finished site actually looks like.

    Frequently Asked Questions

    Do I need planning permission to lay a new driveway in the UK?

    In England, you need planning permission to pave over more than 5 square metres of front garden with an impermeable surface unless water drains to a lawn, border or soakaway on the same property. Using permeable block paving or a gravel surface avoids this requirement entirely. Rules differ in Scotland, Wales and Northern Ireland, so always check with the local planning authority.

    What sub-base depth do I need for a residential block paved driveway?

    For a standard domestic driveway with light vehicle use, a minimum of 150mm of compacted MOT Type 1 sub-base is the accepted industry standard. For heavier use or softer ground conditions, increase this to 200mm. For permeable block paving, use an open-graded sub-base such as Type 3 rather than Type 1, as the dense-graded material will restrict drainage.

    What is permeable block paving and why would I specify it?

    Permeable block paving uses wider joints filled with grit or purpose-made porous blocks to allow rainwater to pass through into a free-draining sub-base below. It eliminates the need for planning permission on driveways in England over 5 square metres and reduces surface water runoff. It does require a specific open-graded sub-base build-up, so the specification differs from standard impermeable block paving.

    How much should I charge for laying block paving as a UK tradesman?

    A two-man team can typically lay 40 to 50 square metres of block paving per day on a prepared sub-base. Materials typically run £20 to £40 per square metre depending on block type, plus sub-base, edging and bedding materials. Day rates across England for experienced paving crews sit between £350 and £500 per person, so factor in all costs including any excavation, skips and drainage work before setting your final price.

  • Soil Pipe and Drainage Layout on UK Extensions: What You Must Get Right Before You Pour the Slab

    Soil Pipe and Drainage Layout on UK Extensions: What You Must Get Right Before You Pour the Slab

    Get the drainage wrong on an extension and you’re in trouble before the first brick goes up. I’ve seen jobs where the slab was poured, the blockwork was three courses high, and then Building Control flagged a soil pipe that had nowhere sensible to go. Ripping up freshly laid concrete is expensive, embarrassing, and entirely avoidable. Planning your extension drainage layout to UK Building Regulations standards before groundworks start is one of those things that looks like admin but is really site management at its most fundamental.

    Extension drainage layout trench with PVC soil pipes bedded in gravel before backfilling
    Photo by Đậu Photograph on Pexels

    What Part H of the Building Regulations actually requires

    Part H covers drainage and waste disposal for England and Wales. The Approved Document H sets out the performance requirements for foul drainage: pipes must carry wastewater away without leakage, blockage or smell, and the system must be accessible for maintenance. That last point is where most extension drainage layouts fall short. Accessibility means rodding eyes in the right places, access chambers at changes of direction, and inspection chambers sized correctly for the depth of the drain.

    For a single-storey kitchen or utility extension, you’re typically connecting back into an existing below-ground drain run. For a two-storey extension with a new bathroom above, the soil stack situation gets more involved. Either way, the Approved Documents are freely available on gov.uk, and I’d recommend downloading Part H before you finalise any drainage drawing. The inspector will have it open on their tablet when they visit, so you may as well work from the same document.

    Fall gradients: what the numbers mean on site

    The standard guidance for a 100mm foul drain is a minimum gradient of 1:80 and a maximum of 1:40. For a 150mm drain you’ve got more flexibility, typically working between 1:150 and 1:80. These aren’t arbitrary figures. A drain that’s too flat won’t self-cleanse; solids drop out, grease builds up, and you get blockages. A drain that’s too steep runs too fast, the liquid outpaces the solids, and you end up with the same problem.

    On a real extension job, calculating your fall means knowing the invert level of your connection point, the distance you’re running, and what gradient fits in between. If you’re connecting to an existing manhole at the back of the garden, measure the invert (the inside bottom of the pipe), then work backwards to your new gully or soil pipe outlet. Sketch it on paper before anything gets dug. A 10-metre run at 1:80 gives you a drop of 125mm. If your connection point doesn’t give you that clearance below finished floor level, you have a problem to solve before groundworks start, not after.

    Single-storey vs double-storey extensions: where it gets more complicated

    A single-storey rear extension is usually straightforward. You’re dealing with ground-level drainage: a new gully for the kitchen sink, perhaps a WC connection if it’s a ground-floor cloakroom, and a short drain run back to the existing system. Get your levels right, bed the pipes properly on granular material, and install an access point at any change of direction greater than 45 degrees. Job done.

    A double-storey extension changes the picture significantly. Now you’ve got an above-ground soil stack to design as well, and the point where that stack exits through the ground-floor slab and goes below ground is a critical detail. The stack needs a foot bend at the base, a minimum 200mm radius, and ideally a rest bend rather than a tight quarter-bend. Below ground from that point, the drain needs to be bedded in Class B granular fill (10mm pea gravel or similar) with at least 100mm under the pipe and 150mm over it before you start backfilling with selected fill. This isn’t optional; it’s in the spec for a reason, and inspectors check it.

    Rodding eyes and access chambers: getting the layout right

    Part H is clear that drains must be accessible for maintenance and rodding. In practice, this means an inspection chamber or rodding eye at every change of direction, at every junction, and at intervals no greater than 45 metres on a straight run. For most domestic extension drain runs, you won’t need to worry about the 45-metre rule, but junctions and bends are everywhere.

    A rodding eye at ground level is the minimum for a straight-ish run with no major changes of direction. For anything more complex, particularly where a new drain joins an existing run, a full inspection chamber is better practice and will sail through Building Control sign-off without question. Pre-cast concrete inspection chambers are the traditional choice; PVC inspection chambers from manufacturers like Polypipe or Brett Martin are quicker to install and just as compliant. Depth dictates which you use: shallow chambers under 600mm deep can use a standard plastic unit, but once you’re going deeper you’ll want to think about confined space access and size the chamber accordingly.

    If you’re building over or close to an existing drain, you’ll also need to check with your water authority. Building within 3 metres of a public sewer requires consent under Section 174 of the Water Industry Act 1991. Don’t assume that because it’s in your garden it’s private. Some older properties have adopted public sewers running through back gardens that the owner knows nothing about. Get the sewer records before you spec the extension footings.

    Coordinating with Building Control before groundworks start

    This is the bit that catches people out. Building Control inspections on drainage typically happen at three stages: drain layout inspection before backfilling, drain test (usually a water test held at 1.5m head for a specified period), and final connection inspection. If you backfill without getting the drainage inspected, you’ll be asked to dig it up. It happens.

    Submit your drainage layout drawing with your full plans application or at the very latest before groundworks begin. The drawing doesn’t need to be an architect’s masterpiece, but it does need to show pipe sizes, gradients, invert levels at key points, access chamber locations and dimensions, and how the new drain connects to the existing system. Your Building Control officer will tell you if they need anything else. Ring them. They’d rather answer a question before the dig than issue a non-compliance notice afterwards.

    If you’re working under a practical completion deadline, factor in that drainage sign-off takes time. Stage inspections need to be booked, and some local authorities are running with limited inspector availability. Build the inspection hold points into your programme, not as an afterthought.

    Common mistakes that fail inspections

    Insufficient cover over the pipe is one of the most common. Under a slab, you generally need 100mm of concrete above the top of the pipe, or the pipe needs to be sleeved. Under a garden or soft landscape, minimum cover is typically 600mm for a private drain. On a driven route under a path or driveway, you might need 900mm or a concrete surround.

    Wrong bedding material is another. Ordinary site spoil under a drain is not acceptable. Granular bedding is specified for a reason: it distributes load evenly, it doesn’t shrink and leave the pipe unsupported, and it allows ground water to move freely rather than building up under the slab. If you’re already thinking about sub-base material choices for groundworks, bear in mind that the bedding under drainage pipes is a separate spec from the sub-base under the slab.

    Missing rodding eyes at junctions is also common, particularly where a ground-floor WC connection meets the main drain run. Fit the access point, even if it adds twenty minutes. The alternative is cutting into a buried junction in five years’ time when there’s a blockage.

    When to use a drainage design consultant

    For a straightforward rear extension on a typical terraced or semi-detached house, a competent builder or groundworker can produce a compliant drainage layout without specialist input. But if the site has complex levels, a basement element, multiple discharge points, or the extension involves building over an existing sewer, bring in a drainage engineer. The cost is small relative to the cost of getting it wrong. For basement extensions in particular, where you may need a pump station to discharge below the public sewer invert, drainage design really isn’t something to guess at. You’ll want to look at waterproofing and drainage together; the approach is similar to the one covered in the guide on basement waterproofing system options.

    Get the levels right, get the access in the right places, talk to Building Control before a spade goes in the ground, and you’ll have drainage that passes first time and lasts the life of the building.
